HANGING LINE

Precision machinery at work in Samsung Hanging Line project by Warehouse International Pvt. Ltd.

HANGING LINE PROJECT

  • Location : Noida
  • Client Name : samsung
  • Project done by: Warehouse International Pvt Ltd

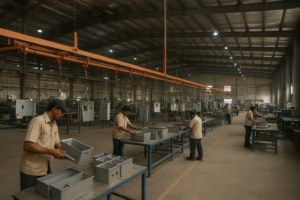

HANGING LINE PROJECT Image

Warehouse International Pvt. Ltd. (WIPL) successfully designed and implemented a Hanging Line System at Samsung’s Noida manufacturing facility. The project was aimed at enhancing assembly efficiency, space utilization, and quality control within Samsung’s high-volume production setup.

This specialized line was engineered to support continuous operations while ensuring safety, precision, and durability. By creating a tailored solution, WIPL has helped Samsung streamline its production flow and achieve higher output consistency.

Objective of the Project

The project’s core objective was to:

  • Develop a customized hanging line to support Samsung’s product assembly and transportation needs.

  • Maximize factory space utilization by introducing overhead handling solutions.

  • Ensure continuous material flow without manual handling delays.

  • Reduce risks of damage and contamination during assembly or movement.

  • Improve ergonomics and worker efficiency by minimizing manual lifting and carrying.

Design & Technical Features

The Hanging Line system was engineered with precision to meet Samsung’s high-quality standards and was tailored to their specific production workflow. Key design features included:

  1. Customized Overhead Conveyor System

    • Designed to transport products and components securely in a suspended manner.

    • Enabled smooth, consistent movement across multiple assembly stations.

    • Adjustable height and hooks to accommodate different product sizes.

  2. High Load-Bearing Capacity

    • Robust structure with reinforced frames and trolleys to handle varied product weights.

    • Safety locks and balancing systems to ensure stability of suspended items.

  3. Space Optimization

    • By shifting handling operations overhead, valuable floor space was freed up for assembly stations, tools, and worker movement.

    • Enhanced lean manufacturing layout with better process flow.

  4. Automation & Integration

    • Compatible with Samsung’s existing production systems.

    • Provision for automation upgrades, including motorized movement, speed control, and integration with other conveyor systems.

  5. Safety & Reliability

    • Designed with worker safety as a top priority – secure hanging mechanisms, anti-fall protection, and emergency stop systems.

    • Smooth operation with minimal vibrations, reducing risk of product damage.

Execution Timeline

  • Planning & Design Phase (20 days):
    Detailed site study, workflow mapping, and 3D layout design.

  • Fabrication & Custom Engineering (40 days):
    Manufacturing of frames, hooks, and conveyor elements tailored to Samsung’s requirements.

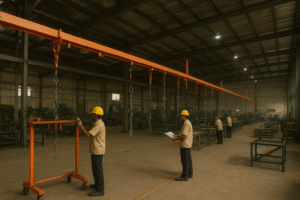

  • Installation & Integration (20 days):
    On-site installation, alignment, and integration with Samsung’s assembly operations.

  • Testing & Commissioning (10 days):
    Load tests, safety validation, and trial runs before handover.

Total Duration: 90 days

Client Benefits

  1. Higher Productivity

    • Continuous material movement supported Samsung’s large-scale production needs.

    • Reduced manual handling improved worker efficiency and output.

  2. Better Space Utilization

    • Freed up 20–30% of floor space for assembly operations.

    • Optimized flow of people, tools, and machinery in the facility.

  3. Improved Product Safety & Quality

    • Minimized risk of scratches, bending, or damage caused by manual carrying.

    • Consistent handling led to better quality control.

  4. Cost Savings & Long-Term Value

    • Reduction in labor dependency lowered operational costs.

    • Strong, durable design ensured long service life with minimal maintenance.

Outcome & Significance

The Hanging Line Project at Samsung, Noida has become a benchmark installation for Warehouse International Pvt. Ltd. It not only fulfilled Samsung’s requirements but also exceeded expectations by delivering:

  • Precision engineering

  • On-time execution within 90 days

  • High-capacity handling system that supports continuous production

This project strengthened WIPL’s position as a trusted partner for world-class manufacturing solutions in India, proving their capability to deliver innovative, efficient, and safe material handling systems for global clients.
